  Work process

Work Process and removal of existing structures

Traffic flow management and installation of some safety facilities, including scaffolding for temporary work to get rid of the elevated highway and the protective screens

Removal of the upper plate, horizontal support, concrete in the central section, beams which were cut into pieces, including carrying them into a suitable storage place

Cutting the elevated highway pier into pieces and transportation

Intercepting sewers being fixed. Two-lane roads being built on both sides of the stream.

Work for re-shaping the stream, landscaping. And installation of lights

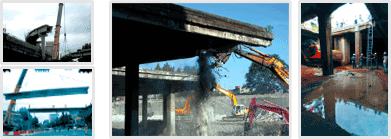

Removal of structures
The work for removing the concrete and the elevated highway over the stream started on July 1st, 2003. The total amount of removed structures included 5.86km-long structure of elevated highway, 5.48km of concrete, 5.0km of intercepting sewer, and 0.30km of sewer culverts.

The work process was being divided into Phase-1: Removal of ramps, Phase-2: Removal of the upper plates of the elevated high way, Phase-3: Removal of the piers supporting the elevated highway, and Phase-4: Removal of the concrete covering up the stream. Structures removed included 371 piers supporting the elevated highway, 6,700 piers supporting the concrete, 10 ramps, and 7 land bridges, in addition to the elevated highway and the concrete.

The entire section was divided into three sectors for the removal work, i.e. Sector-1 (Taepyeongno ~ Gwangjang Market) (2km), Sector-2 (Gwangjang Market ~ Nangyero), and Sector-3 (Nangyero ~ Sindapcheolgyo (Railroad Bridge, 1.7km). The removal work was carried out under the three-shift system (i.e. by a total of nine teams) for each sector.

Removal of ramps

- The one-lane, 5m-wide ramps were supported by some piers standing every 24 meters.
  They were cut into 24m x 5m-sized pieces and removed with a crane.
- For Sector-1, where there used to be only one lane open between the ramps and the sidewalk, a
  crane was made to work on the elevated highway in order to secure a lane for vehicles passing
  by on the ground level.
- For Sectors 2 and 3, there were two lanes open between the ramps and the sidewalk.
  Thus, a crane was placed beneath the ramps to remove the ramp and piers were cut into
  pieces, securing spaces gradually.

Removal of the piers supporting the elevated highway

- Most of the piers were shaped like a regular hexahedron which sides are one meter or two
  meters long.
The piers were being cut to a given size, using a diamond wire saw and then moved with a crane. Efforts were made to reduce noise and dusts by sprinkling sufficient amount of water.

Removal of concrete covering up the stream

- First, the work was carried out to separate the two-lane section of the street on both sides
of the stream that would remain in place after the removal work from the section to be
removed, using a circular saw. Beneath the concrete, some supporting piles were placed to
prevent from an abrupt collapse of the concrete. The concrete was removed, using some
hydraulic breakers.
